Construction Risk Indicators Checklist for ERP-Driven Projects

Construction manager with blueprint at job site

Start monitoring these nine key risk indicators (KRIs) this week: change order rate, budget variance trend / EAC drift, contingency burn rate, Schedule Performance Index (SPI), critical path float erosion, RFI response time, subcontractor payment days outstanding, labor availability gap, and rework cost %. Your single next action: pick 3–5 of these aligned to your current portfolio’s biggest exposure, assign a named owner to each, and configure threshold alerts in your ERP within seven days.

Here is your first-week checklist:

Key Takeaways

Monitoring a set of 3–5 validated leading KRIs in your ERP, tailored to your portfolio’s biggest exposure and assigned to named owners with short escalation SLAs, gives you a meaningful warning advantage over teams relying solely on monthly EVM reports.

Point Details
Start with 3–5 KRIs this week Select 3–5 KRIs from nine validated options, matching them to your portfolio’s main risk exposure, and assign one named owner per KRI.
Validate data before automating Run a two-week manual parallel to fix cost-code mapping errors before enabling automated alerts.
Calibrate thresholds from your history Use median and 75th-percentile values from your last 10–20 projects to set green/amber/red bands.
Run your first KRI review in 30–90 days Recalibrate thresholds after 60–90 days of live data and expand coverage across the portfolio.
Designflow-build Configures cost, schedule, and cash-flow KRI alerts in 2–4 weeks with 98% reported adoption.

Table of Contents

Why leading KRIs outperform traditional project controls

Traditional earned-value management (EVM) measures like CPI and SPI are calculated monthly from actuals already posted. By the time a red flag appears in a monthly report, the cost or schedule damage is done. Leading KRIs surface the conditions that cause overruns before they show up in the numbers.

The Project Health Indicator (PHI) tool from the Construction Industry Institute identifies 43 leading indicators that provide real-time early warning signs of project health and are designed to complement, not replace, traditional EVM and schedule measures. The PHI maps those indicators to five outcomes: cost, schedule, quality/operability, safety, and stakeholder satisfaction.

Research signal: Orgut et al. (ASCE) validated 20 core metrics, 7 validation metrics, and 7 innovative metrics across a study sample and found that projects using more core and diagnostic metrics consistently showed better cost and schedule performance.

The practical implication: a construction risk indicators checklist built on validated leading metrics is thought to provide a 2–4 week head start over teams relying on monthly EVM alone. That window is usually enough to course-correct before a variance becomes a claim.

Key reasons to add leading KRIs to your ERP reporting:

Cost KRIs checklist: what to track, who owns it, and how often

Real-time budget tracking keeps budgets and actuals synchronized so these KRIs reflect current exposure, not last month’s snapshot.

Pro Tip: Map committed costs separately from incurred costs in your ERP cost codes before enabling KRI alerts. If your change order rate calculation pulls only posted actuals, it will miss approved-but-not-yet-billed commitments and understate exposure by 15–30% on active subcontracts.

Schedule KRIs checklist: protect the critical path and detect float erosion

Designflow-build’s CPM, Monte Carlo, and DCMA scheduling support integrates directly with project cost data, so SPI and float erosion KRIs update from a single source rather than requiring manual exports from a standalone scheduler.

Pro Tip: SPI can mask critical-path risk on projects with many non-critical activities. Track total float on the five longest critical-path chains separately. A project with SPI of 0.92 but zero float on its mechanical completion path is in far worse shape than the index suggests.

Financial and cash-flow KRIs checklist to protect liquidity

An AI forecasting layer ingesting live ERP data can flag 30-day cash gaps before they materialize, but it needs roughly 60–90 days of live data to stabilize approval-cycle and payment-pattern estimates. Plan that learning window into your rollout timeline.

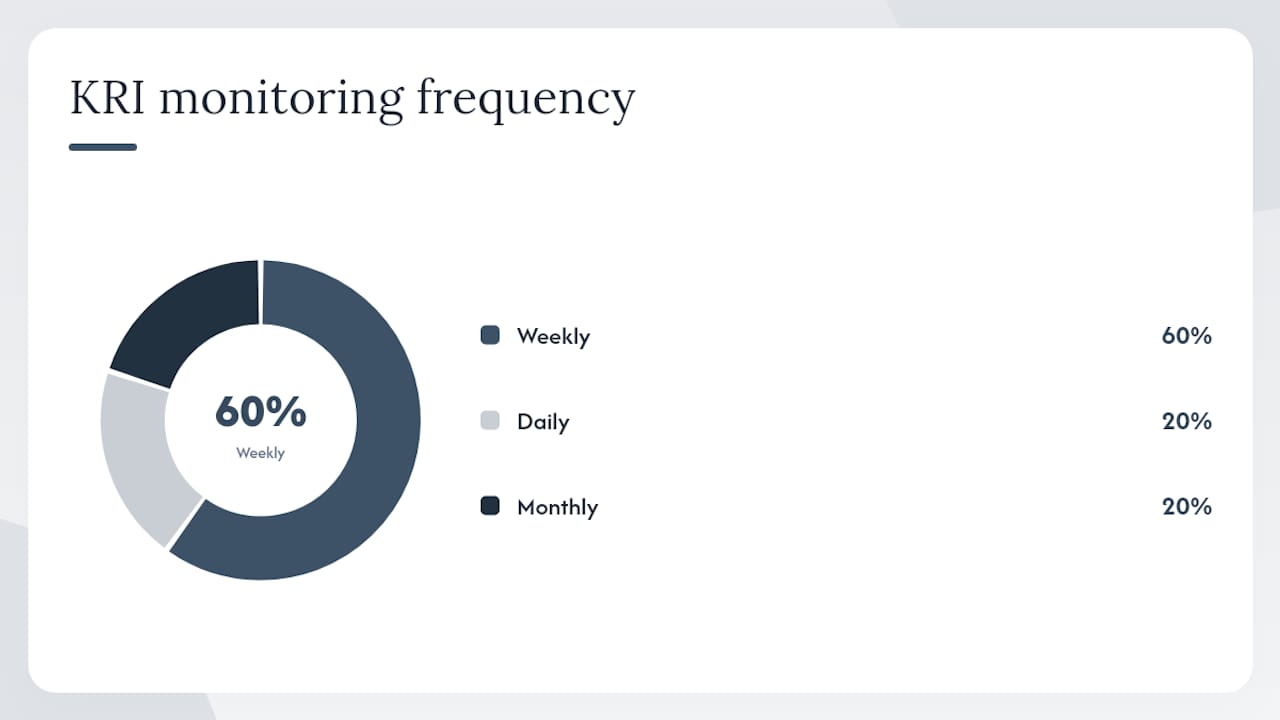

Resources and procurement KRIs checklist: labor, subs, and materials

KRI What It Measures Green Amber Red Data Source Owner Frequency
Labor availability gap Actual crew vs. planned crew (% below plan) <5% 5–15% >15% HR / field app Operations lead Daily
Subcontractor default / turnover flag # of subs with payment disputes or mobilization delays 0 1 >1 ERP AP + procurement Procurement lead Weekly
Long-lead item delivery variance Days late vs. scheduled delivery 0 days 1–7 days >7 days Procurement / ERP Procurement lead Weekly
Material price escalation index Actual unit cost vs. bid-time unit cost (%) <3% 3% >3% ERP procurement Cost controller Monthly
Vendor invoice dispute rate % of invoices disputed or on hold <2% 2–5% >5% ERP AP Procurement lead Weekly

Resources and procurement KRIs checklist: labor, subs, and materials — overview diagram

Pro Tip: Connect supplier portals or EDI feeds directly to your ERP procurement module. Manual data entry for delivery confirmations and invoice status introduces 3–5 day lags that make labor and material KRIs stale before anyone reads them.

How to pick your 3–5 KRIs, set thresholds, and assign ownership

  1. Map KRIs to your portfolio’s biggest risk exposure. A cash-heavy GC with thin margins should prioritize DSO, contingency burn rate, and billing-to-earned ratio. A schedule-driven design-build firm should lead with SPI, float erosion, and RFI response time. Match the KRI set to where your projects actually bleed.

  2. Calibrate thresholds from historical data. Pull your last 10–20 completed projects from your ERP. Calculate the median and 75th-percentile values for each candidate KRI. Set green at or below the median, amber between median and 75th percentile, and red above it. This grounds thresholds in your own performance history, not generic benchmarks.

  3. Assign one named owner per KRI. Shared ownership means no ownership. Each KRI gets one person responsible for the number, one person who acts on amber, and one escalation path for red. Document the SLA: amber triggers a corrective action plan within 48 hours; red triggers an executive review within 24 hours.

PMO ownership checklist:

A practical KRI framework recommends limiting each domain to 3–5 KRIs to maintain signal quality and avoid alert fatigue during the first 90 days.

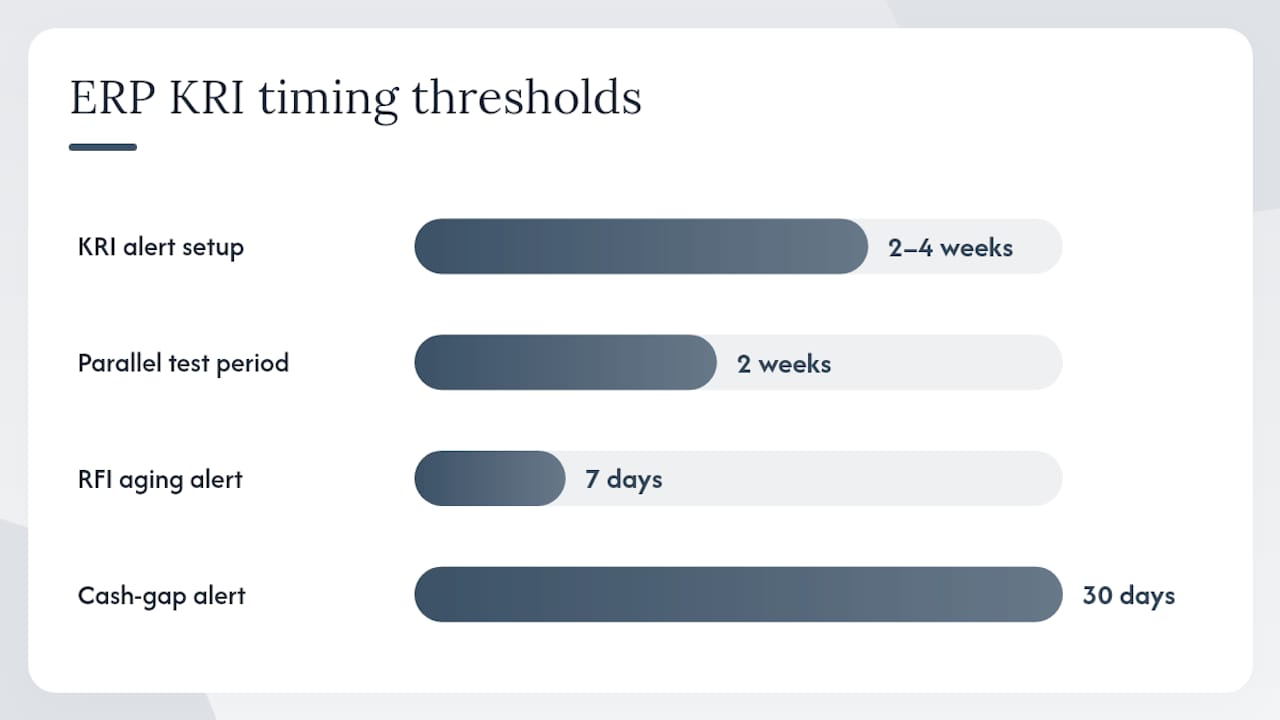

Implementing KRIs in your ERP: integrations, alerts, and predictive layers

Required data integrations before enabling automated KRI alerts:

Automation examples that reduce manual effort:

Designflow-build supports CPM, Monte Carlo, and DCMA scheduling natively, so schedule-driven KRI cards can be configured without a separate scheduling integration project. A typical KRI alert setup runs 2–4 weeks from data mapping to live dashboard.

Pro Tip: Before enabling automated alerts, run a two-week parallel test: calculate each KRI manually and compare to the ERP output. Mismatches almost always trace to committed-vs.-incurred mapping errors or cost-code misclassifications. Fix those first, or your alerts will generate noise from day one.

Implementing KRIs in your ERP: integrations, alerts, and predictive layers — overview diagram

KRI dashboard design and weekly/monthly reporting

A single-page KRI dashboard should include:

Weekly report contents: all amber and red KRIs, one-line corrective action per item, owner, and due date. Keep it to one page. Monthly executive pack adds EAC movement vs. prior month, a portfolio heat map showing red KRIs by project, and a contingency reserve summary.

Reporting signal: ERP-driven executive reporting that normalizes KPIs across projects gives leadership a single version of backlog, committed cost, and risk, which is the foundation for reliable portfolio-level decisions.

30–90–180 day rollout plan to operationalize KRI monitoring

Common pitfalls when starting a KRI program and how to fix them

Methodology and sources behind this checklist

This checklist draws on two validated research foundations:

The PHI tool (Construction Industry Institute) maps 43 leading indicators to five project outcomes: cost, schedule, quality/operability, safety, and stakeholder satisfaction. Each indicator has a guidance sheet for measurement, making it directly configurable in an ERP.

The Orgut et al. ASCE study used a Delphi validation process with subject-matter experts and statistical analysis across a project sample to confirm that 20 core and 7 diagnostic metrics correlate with better cost and schedule outcomes. The KRIs in this checklist map directly to that validated core set.

Validation signal: Projects using more core and diagnostic metrics from the Orgut et al. study consistently showed better cost and schedule performance, providing statistical backing for the KRI selection approach here.

The checklist also aligns with the RiskPublishing KRI framework, which recommends 3–5 KRIs per domain, owner assignment, and short measurement cadence as the minimum viable governance structure. The financial waste checklist from Designflow-build provides complementary quick-win assessment steps for baseline data collection.

What actually works in practice for KRI programs

Most KRI programs fail in the first 90 days for one reason: the data isn’t ready. Teams configure dashboards before they’ve validated that cost codes are consistent, committed costs are mapped correctly, and scheduling data syncs reliably. The result is a beautiful dashboard full of misleading numbers, and once owners lose trust in the data, they stop looking.

Start with data quality, not dashboard design. Run a two-week manual parallel before you automate anything. Fix the mapping errors you find. Then turn on the alerts.

The second failure mode is ownership without accountability. Assigning a KRI to a role title (“the PM”) rather than a named person means the alert sits in a shared inbox. Name the person. Set the SLA in writing. Review it in the weekly meeting. That combination, named owner plus short escalation SLA plus standing agenda item, is what separates a KRI program that drives decisions from one that generates reports nobody reads.

Automation is the goal, but human review during the learning window is what gets you there reliably.

Designflow-build gets your KRI program live in 2–4 weeks

Most ERP implementations take months and require a team of consultants. Designflow-build is built differently: AI-native, with CPM/Monte Carlo scheduling, automated change-order tracking, real-time job costing, and predictive cash-flow scoring all in one platform. You can configure change order rate and contingency burn alerts in the same week you map your cost codes, not six months later.

Designflow-build

The 98% adoption rate and 2–4 week implementation timeline mean your team is reviewing live KRI dashboards before the end of your first month, not still in training. The reported 70% reduction in manual data entry means your owners spend time acting on alerts, not building spreadsheets to produce them. View the AI-native ERP platform or explore scheduling and KRI configuration to see how the setup works. Request a demo and have your first three KRI cards configured within the week.
